BRIDGE BULLETIN

Volume 2 Issue 5 - June 2026

Welcome to our newsletter!

Project updates, employment information, and more!

It's More than Just a Bridge

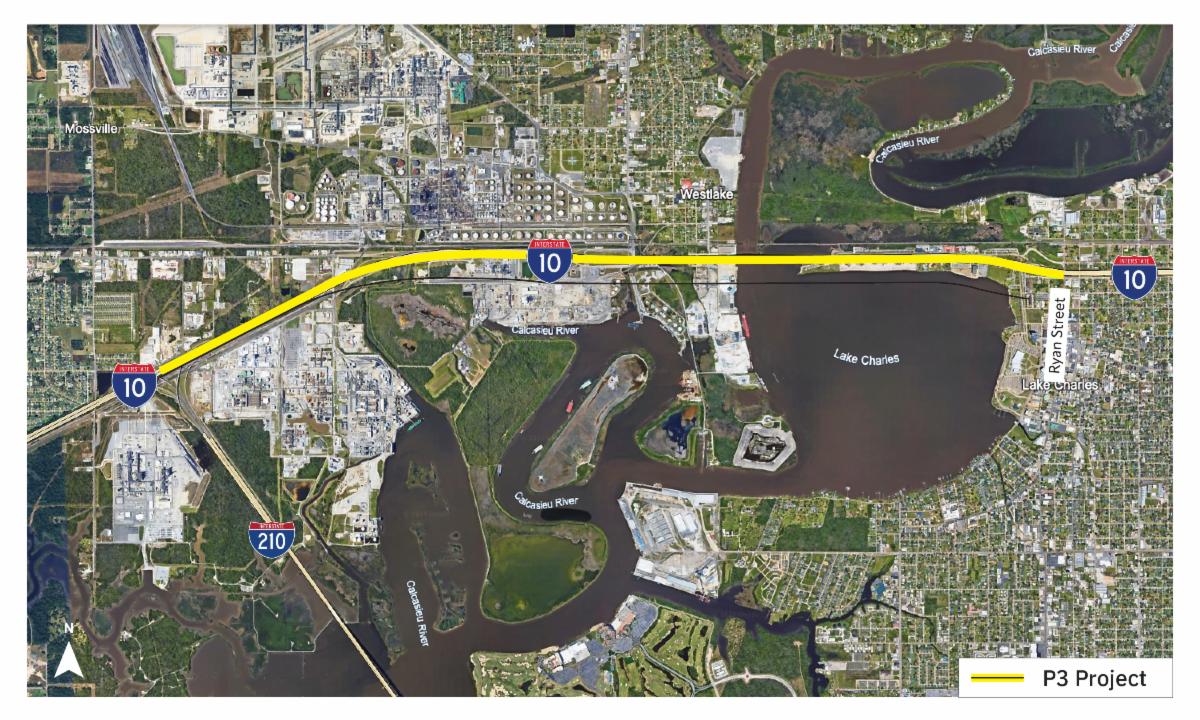

When we talk about the I-10 Calcasieu River Bridge Replacement Project, it is easy to focus all our attention on the main span over the water. While the new bridge will undoubtedly be a monumental addition to our skyline, the reality of this massive undertaking stretches far beyond the riverbanks. The truth is, this project is more than just a bridge. It is a comprehensive transformation of an approximately 5.5-mile corridor that will redefine travel through the region.


This 5.5-mile stretch is a critical artery for local commuters and national freight alike. To ensure the new infrastructure meets the demands of tomorrow, the project scope includes a series of major roadway and structural enhancements designed to improve safety, alleviate congestion, and increase overall mobility. These corridor-wide improvements are just as vital to the project's success as the span that will cross the river.

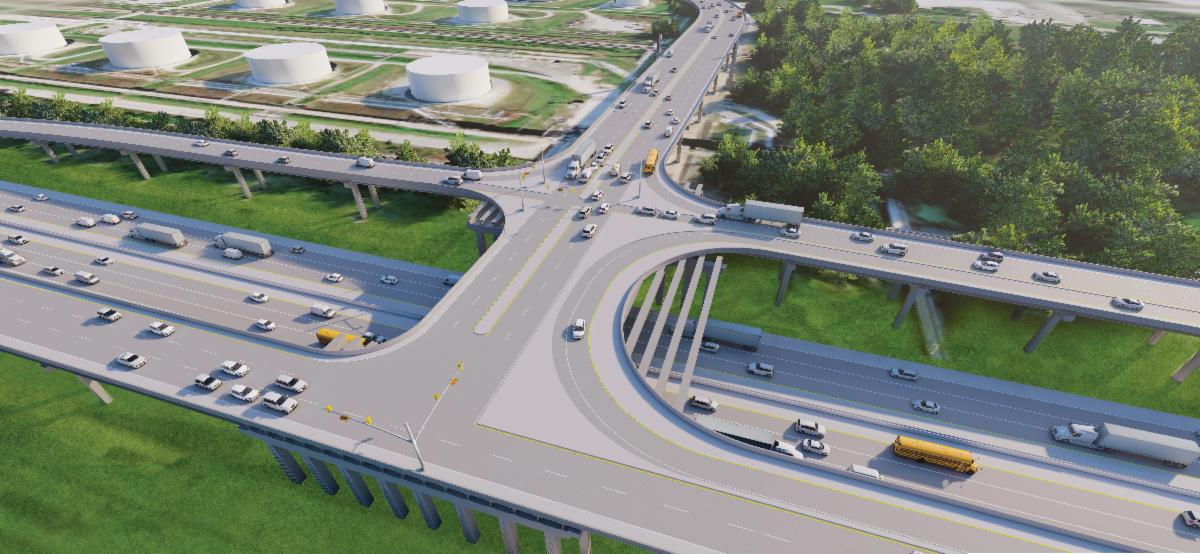

A major component of this corridor transformation is the construction of a new I-210 Westbound ramp to prepare for the widening and new alignment of the roadway. These additions are engineered to significantly improve local traffic flow, allowing drivers to navigate between local destinations more efficiently without having to merge into interstate traffic. By better separating local trips from thru-traffic, the project creates a safer and smoother experience for everyone on the road.


Within the project area, crews will be upgrading or completely replacing approximately 15 other bridges. These secondary structures are crucial links in our local transportation network. Bringing them up to modern design and safety standards is a massive undertaking that will ensure the longevity and reliability of the entire I-10 corridor.


Another significant milestone within the corridor is the construction of the new Sampson Street overpass. This specific improvement will alleviate existing traffic bottlenecks and improve the intersection's overall capacity. For the surrounding neighborhoods and local businesses that need steady, predictable access, this overpass will provide a major quality-of-life upgrade.

The project isn't exclusively focused on motorized vehicles, either. Through funding from an active transportation allowance, a $10M investment, the project will incorporate bicycle and pedestrian facilities near the bridge on both sides of the river. These additions reflect a modern, community-centered approach to infrastructure, ensuring that residents have safe, accessible, and active alternatives to navigate the area.


Beneath the surface, the project is also building for the future through the installation of a common duct bank. This will serve as a common underground utility hub for safe and convenient access to utility lines. By installing this framework now, we protect critical infrastructure and drastically reduce the need for future lane closures or roadway excavations when maintenance or expansions are required.


Every new overpass, upgraded bridge, and paved service road is a deliberate stepping stone toward a safer, more connected, and economically vibrant region.

Project Milestones

Recent/Completed

  • Roadway repairs on I-10 Eastbound (May)
  • Construction of access road between Miller Avenue and Sampson Street (started in May)
  • Construction of temporary access for the east approach of the Main Bridge (started in May)
  • Test drilled shafts in four locations to analyze load bearing capacity. Load testing completed in two locations (May/June)

Upcoming

  • First permanent pile to be driven (June)
  • Removal of the west side trial embankment (June)
  • Power lines to be removed on North Lakeshore Drive near the Calcasieu River to continue building the trestle (June)
  • Demolition of buildings east of Miller Avenue (June/July)
  • Lakeshore Drive widening (summer)

NOTE: All timelines are subject to change

The P3 Advantage:

Protecting the Taxpayer ROI

To manage the cost of the biggest infrastructure project in LA DOTD history, the state utilized a Public-Private Partnership (P3) with Calcasieu Bridge Partners (a consortium of ACCIONA, Sacyr, and Plenary).


From an ROI perspective, this model is highly strategic for the state:


  • Risk Transfer: The heavy financial risks of cost overruns and construction delays have been shifted away from taxpayers and onto the private developer.
  • 50-Year Guarantee: The P3 agreement includes dedicated maintenance of the new roadway and bridge for a 50-year term, ensuring the asset never falls into a state of disrepair.
  • State Equity: Louisiana retains a 15-percent equity share in the tolling revenues generated by the project. This will be a continuous, long-term funding stream to reinvest back into state infrastructure.


Ultimately, by leveraging this partnership, the state isn't just funding a massive construction project; it is securing a long-term financial strategy. The P3 model transforms a staggering multibillion-dollar expense into a protected, self-sustaining asset, ensuring that the Calcasieu River Bridge will reliably serve Louisiana’s taxpayers (and its economy) for generations to come without becoming a future financial burden.




View our video explaining a P3



Vendors interested in working on the project must register on the Procurement Portal to be considered for future engagement.


For job seekers, the careers page lists current available positions.
