|
Timeline
Project construction is scheduled to begin on July 31, 2024 and end in November 2025. The traffic maintenance plan for this construction site will be in place 24/7 during this project.
Construction work hours are weekdays from 7 a.m. to 6 p.m., with most Saturdays approved. Extended time is subject to city approval and community notification.
Construction will be completed in four phases:
Phase 1: Belle Isle to Dade Boulevard
- Water main: August 2024 - September 2024
Phase 2: San Marco to San Marino
- Water main: September 2024 - November 2024
- Connection: April 2025
Phase 3: San Marino to Di Lido
- Water main: October 2024 - December 2024
- Sewer main: December 2024 - January 2025
- Connection: May 2025
Phase 4: Di Lido to Rivo Alto
- Water main: January 2025 - March 2025
- Sewer main: February 2025 - March 2025
- Connection: June 2025 - July 2025
Please know that schedules may change due to weather and unforeseen circumstances.
Traffic Impacts

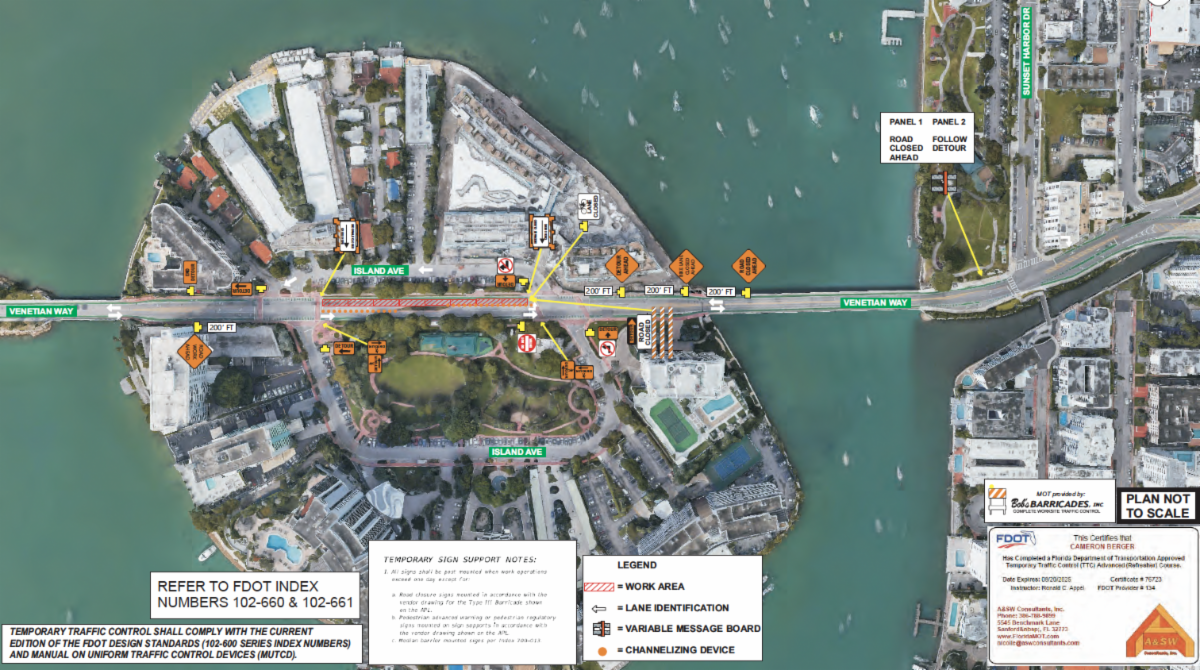

The city will employ all available resources to minimize disruption to residents. Traffic operations will be assisted by off-duty officers and flaggers during special work hours. The following is a breakdown of the upcoming traffic changes for phase I. Please click here to view the project's comprehensive maintenance of traffic (MOT) plan.
Phase 1: July 2024 - September 2024
The following lanes will be closed during Phase 1.
Phase 1a: July 2024 – September 2024
- Westbound lane on Belle Isle will be closed to vehicular traffic. All traffic will be diverted onto Island Avenue north and south.
- Westbound bike lanes on Belle Isle will be closed. Cyclists and vehicles will share the road. Please heed all posted signage.
|
