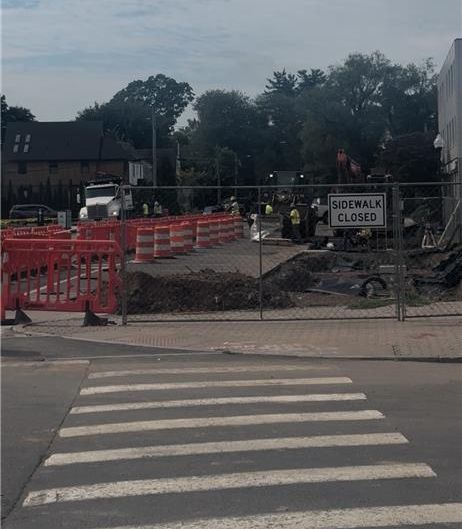

Project Look-Ahead
The contractor will complete work in approximately 100–150 foot increments during Phase 3 in order to minimize disruptions. Project updates will include notice of when the work zone is scheduled to extend, and our team will ensure impacted businesses are kept informed in advance.
Below is a summary of recent work completed and a look ahead at what’s scheduled for the coming weeks (weather permitting):
Week of August 18 – August 22, 2025
- Phase 1-B
- Complete work at the Peoples Bank driveway.
- Phase 3-A
- Complete storm crossing at Friendly Toast.
- Demolish sidewalks in front of Friendly Toast (midweek, either early morning before business hours or after closing).
- Pour sidewalks from Savoy to Friendly Toast (scheduled after Friendly Toast closes at 2:30 PM).
- Phase 3-B
- Backfill soil cells and install curb.
- Extend work area in Phase 3-B to Ellsworth.
Week of August 25 – August 29, 2025
- Phase 3-A
- Extend work area to the alleyway just south of Lux Bond & Green.
- Prepare and pour sidewalks in this area.
- Phase 3-B
- Install the last two sets of soil cells.
- Prepare and pour sidewalks.
|
